Disclaimer. This article is intended for informational purposes only. Construction companies, contractors, and utilities should verify the information, consult qualified safety professionals, and stay up to date with applicable regulations, industry standards, and safety requirements before implementing any practices.

Construction sites come with daily safety risks, from equipment hazards to worker injuries. A construction safety management system (SMS) helps you identify these risks, set clear safety procedures, and protect your workers.

Most contractors already have safety rules. Far fewer have a system, one that keeps working when the safety manager is on another jobsite, when a new subcontractor shows up, or when the schedule gets tight.

This guide gives you a 10-step implementation plan for construction safety management system. It also includes a 90-day rollout timeline, the KPIs to track, and the mistakes that cause most rollouts to stall.

What is a Construction Safety Management System?

A construction safety management system (SMS) is a set of rules and processes that

helps construction teams identify hazards, prevent accidents, and follow safety regulations. It covers worker training, site inspections, incident reporting, and corrective actions to keep workers safe.

A safety management system (SMS) for a construction contractor includes three key elements:

Term What it is Example
Safety program Your written policies and procedures Fall protection program, hazard communication program
Site safety plan How the program applies to one project Site-specific safety plan for a hospital renovation
Safety management system The full cycle that plans, runs, checks, and improves everything above Leadership, roles, hazard assessment, training, reporting, audits, management review

Most construction SMS frameworks follow a Plan–Do–Check–Act cycle. The three most widely used references are:

  • ISO 45001, the international standard for occupational health and safety management systems, used by contractors who want third-party certification.
  • ANSI/ASSP Z10, the U.S. consensus standard for occupational health and safety management systems.

You don’t need ISO 45001 certification to improve construction safety. However, you must

follow applicable safety regulations. The steps below follow OSHA’s recommendations and

can also help you prepare for ISO 45001 certification if needed in future.

Why Construction Companies Need a Safety Management System?

Construction sites involve daily risks, from falls and equipment accidents to electrical hazards and unsafe work practices.

Construction accounts for roughly 5070 fatal incidents in U.S. private industry, and falls are the leading cause.

Without a clear safety process, small issues can lead to worker injuries, project delays, and higher costs.

A construction safety management system (SMS) helps you manage these risks before they become serious problems. It gives your team a consistent way to identify hazards, train workers, inspect job sites, and track safety issues across projects.

Here’s why it matters for your construction business.

  • Prevent workplace accidents. Identify hazards early, assess risks, and put controls in place before someone gets hurt.
  • Meet safety requirements. Keep safety procedures, training records, inspection reports, and incident documentation organized to support compliance with applicable regulations.
  • Reduce project delays and costs. Fewer accidents mean less downtime, fewer disruptions, and lower costs associated with injuries, rework, and claims.
  • Improve worker accountability. Give supervisors and workers clear safety responsibilities so everyone knows what to do and when to report a problem.
  • Maintain consistent safety practices. Apply the same core safety processes across multiple job sites, subcontractors, and teams.
  • Make better safety decisions. Use inspection results, incident reports, and hazard trends to identify recurring problems and improve your safety procedures.

A safety management system helps you move from reacting to accidents to preventing them. It also gives you a clearer view of safety performance across your projects, helping you protect workers while keeping construction work on track.

Prerequisites for Implementing a Construction Safety Management System

Before implementing a construction safety management system (SMS), make sure you have these three things in place.

  1. Management support. Get an executive sponsor who can approve budgets, allocate resources, and make safety a priority when it conflicts with project schedules.
  1. A designated SMS owner. Assign a safety manager or operations lead to oversee implementation, coordinate teams, and track progress.
  1. Baseline safety data. Gather your OSHA injury and illness records (Forms 300 and 300A, where applicable), available insurance loss runs, your current Experience Modification Rate (EMR), and incident reports. Three to five years of loss history can help you identify recurring risks and measure improvements over time.

10 Steps to Implement a Construction Safety Management System

Implementing a construction safety management system takes more than setting safety rules. You need a clear plan to identify hazards, establish procedures, train workers, track compliance, and review safety performance.

Here are 10 steps to help you put a system in place and make safety part of your daily construction operations.

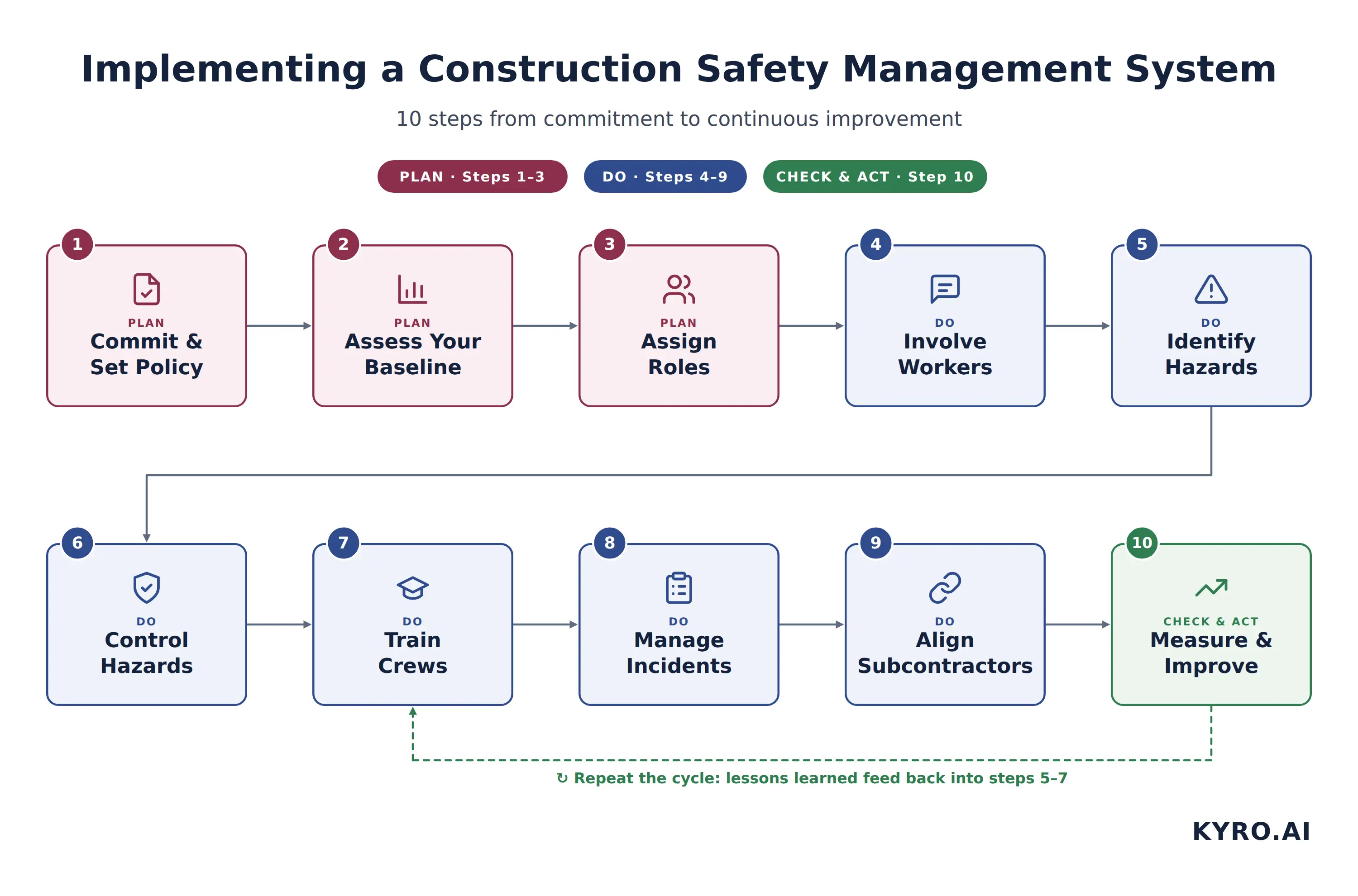

steps to implement a construction safety management system

Step 1: Secure leadership commitment and write your safety policy

Everything else depends on this step. Workers judge safety priorities by what leaders do, not by what the policy says.

Write a one-page safety policy signed by the owner or CEO. It should cover:

  • The company’s commitment to preventing injuries and illnesses
  • Accountability for safety at every level, from executives to crews
  • Every worker’s authority to stop unsafe work without retaliation
  • A commitment to involve workers and to improve continuously

Sample policy statement: “ Our company is committed to sending every worker home safe, every day. Every employee and subcontractor has the authority and responsibility to stop work they believe is unsafe. Leaders at every level are accountable for safety performance, and we will measure, review, and improve our safety management system continuously.”

Then back the policy with visible behavior: leaders who walk jobsites, review safety metrics in every operations meeting, and fund fixes when hazards are found.

Step 2: Conduct a baseline assessment and gap analysis

You can’t improve what you haven’t measured. Start with four activities.

Calculate your current rates. Total Recordable Incident Rate (TRIR) shows how often recordable injuries occur:

TRIR = (Recordable cases × 200,000) ÷ Total hours worked

For example, a contractor with 500,000 hours worked and 7 recordable cases has a TRIR of 7 × 200,000 ÷ 500,000 = 2.8. Calculate DART (days away, restricted, or transferred) the same way using only DART cases. See TRIR vs. DART for more.

Analyze incident history. Look for repeat injury types, tasks, trades, and sites over the past three years. These patterns tell you where to focus first.

Audit your written programs against the OSHA construction standards (29 CFR 1926) that apply to your work.

Survey workers anonymously. Ask whether they feel safe reporting hazards and near misses, and whether they’ve ever been pressured to skip a safety step.

Capture the results in a gap analysis:

SMS Element Current State Gap Priority Owner
Hazard assessment JHAs done on some jobs, paper only No standard JHA process High Safety manager
Near-miss reporting Informal, verbal No reporting tool or tracking High Safety manager
Training records Spreadsheet, partly current Expired certifications not flagged Medium HR
Subcontractor prequalification COIs collected only No safety criteria Medium Project controls

Still managing hazard reports and site inspections on paper? Explore how KYRO AI can help your team document safety issues and keep records organized.

Step 3: Define roles, responsibilities, and accountability

Safety fails when it belongs to “the safety department” alone. Define what each role owns:

Role Core Safety Responsibilities
Executives Set policy, fund the system, review performance quarterly
Project managers Plan safety into bids, schedules, and subcontracts
Superintendents Run daily site safety, enforce controls, lead incident response
Foremen Lead pre-task plans and toolbox talks, correct hazards on the spot
Workers Follow procedures, report hazards and near misses, use stop-work authority
Subcontractors Meet site requirements, share JHAs, report incidents
Safety manager Own the SMS, coach, audit, and report metrics

Put these responsibilities into job descriptions and performance reviews. Then form a safety committee with management and field representatives that meets monthly, reviews incidents and metrics, and tracks actions to closure.

Step 4: Build worker participation into the system

Workers see hazards first. The system has to make it easy and safe for them to speak up.

  • Make stop-work authority real. Publicly thank people who use it and never penalize a good-faith stop.
  • Treat near misses as free lessons. Make reporting blame-free, fast, and visible. Show crews what changed because of their reports.
  • Involve crews in hazard assessment. Workers who help write a JHA are far more likely to follow it.
  • Remove barriers. Provide materials in the languages your crews speak, and offer reporting methods that don’t depend on typing, such as voice or photo-based reports.

Step 5: Establish hazard identification and risk assessment

Build a routine for finding hazards before work starts, not after someone gets hurt. Use four tools together:

  1. Pre-construction hazard reviews during planning, so major risks are designed or planned for.
  1. Job hazard analyses (JHAs) for each significant task, breaking it into steps and identifying hazards and controls for each.
  1. Daily pre-task plans reviewed by the crew before work begins, because site conditions change daily.
  1. Regular site inspections by supervisors and the safety team.

Use a risk matrix to rank hazards based on how likely they are to happen and how serious the injury could be. Score each from 1 to 5, then multiply the scores.

Hazards scoring 15–25 need immediate action, those scoring

8-14 need planned action, and lower scores should be monitored.


Give special attention to OSHA’s Focus Four construction hazards: falls, struck-by, caught-in or -between, and electrocution.

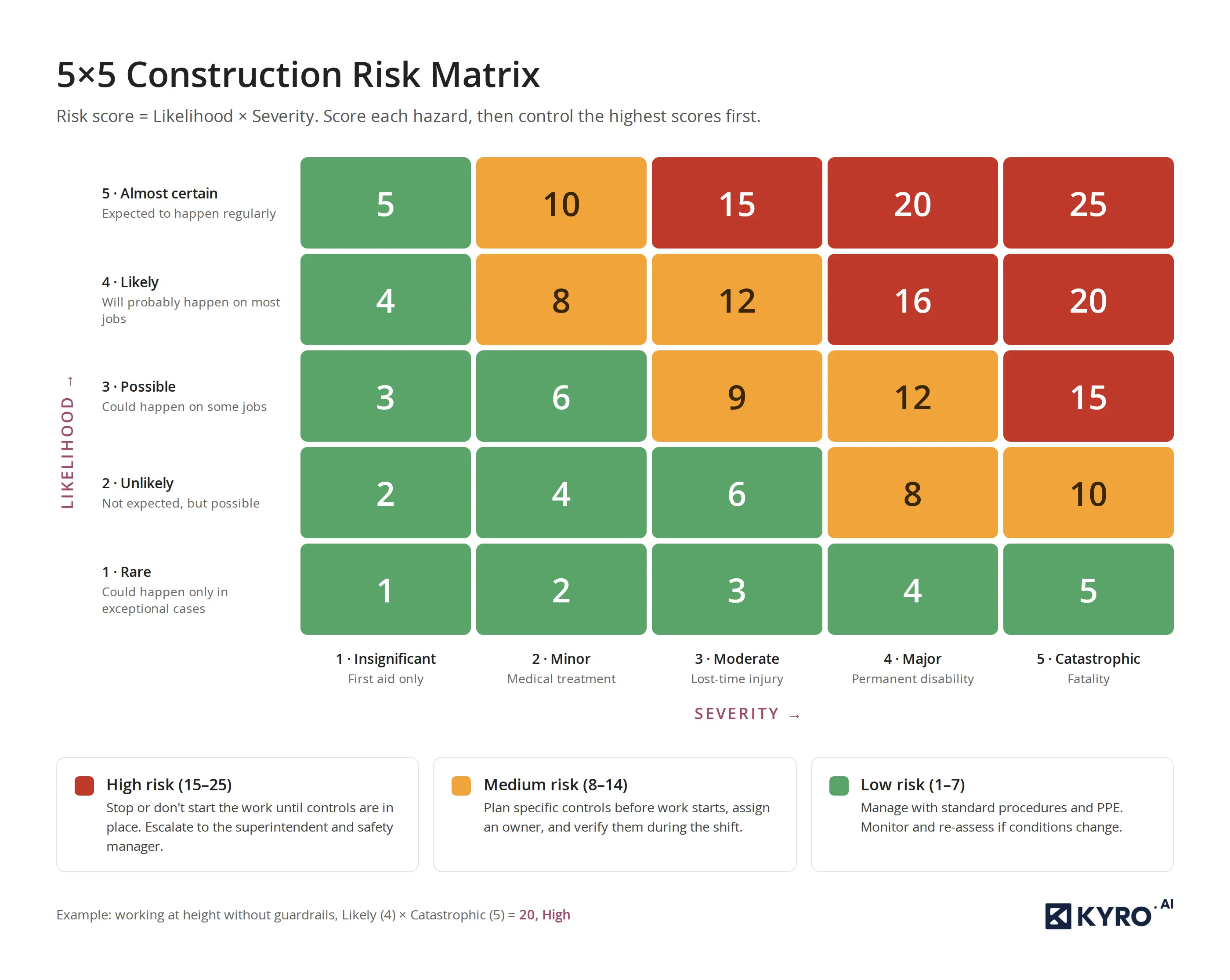

Construction Risk Matrix

Step 6: Implement hazard controls using the hierarchy of controls

Once you identify and rank hazards, the next step is to put controls in place to reduce the risks. Use OSHA’s hierarchy of controls to choose the most effective safety measures, starting with removing the hazard wherever possible.

  • Elimination. Remove the hazard completely, such as assembling equipment at ground level to avoid working at height.
  • Substitution. Replace a hazardous material or process with a safer option.
  • Engineering controls. Isolate workers from hazards using guardrails, machine guards, or barriers.
  • Administrative controls. Reduce exposure through safety procedures, training, warning signs, and work schedules.
  • Personal protective equipment (PPE). Provide hard hats, safety glasses, gloves, and fall protection when needed.

Whenever possible, prioritize the higher-level controls. They reduce risks more effectively than relying on worker behavior or PPE alone.

Not all controls are equal. The hierarchy of controls ranks them from most to least effective:

Level What it means Construction example
1. Elimination Remove the hazard entirely Prefabricate assemblies on the ground instead of working at height
2. Substitution Replace with something less hazardous Use low-silica materials or a less toxic coating
3. Engineering controls Isolate people from the hazard Guardrails, trench boxes, and saws with water delivery for silica
4. Administrative controls Change how people work Permits, exclusion zones, and work rotation in heat
5. PPE Protect the individual Personal fall arrest systems, respirators, and hard hats

Start at the top. PPE is the last line of defense, not the first.

Then make sure your written programs cover the standards that apply to your work. For most contractors, that includes a fall protection plan, hazard communication, excavation and trenching, scaffolding, electrical safety and lockout/tagout, respirable crystalline silica, and heat illness prevention.

Step 7: Train and verify competency

Training works in layers:

  • New-hire orientation on company policies, reporting, and stop-work authority
  • Site-specific orientation for every worker and subcontractor arriving at a new project
  • OSHA 10 and OSHA 30 outreach training for workers and supervisors
  • Task-specific certifications, such as aerial lifts, forklifts, crane operation, rigging, and competent person roles
  • Weekly toolbox talks tied to current work and recent incidents

Verify understanding, not just attendance. Ask workers to explain the hazards and controls for their task and observe them in the field.

Track everything in a training matrix that lists each role, its required training, and renewal intervals, so expiring certifications are flagged before they lapse.

Step 8: Set up incident reporting, investigation, and corrective action

  • Define what to report: injuries, illnesses, near misses, property damage, and unsafe conditions. The more near misses you capture, the more injuries you can prevent. See our guide to near-miss reporting.
  • Investigate to find root causes, not blame. Secure the scene, collect photos and witness statements, and use a method such as the 5 Whys or a fishbone diagram to get past “worker error” to the underlying cause.
  • Close the loop with corrective actions. Each action needs an owner, a due date, and verification that it worked. Track closure rates, because open corrective actions are a common finding when incidents repeat.
  • Meet OSHA recordkeeping requirements. Most employers with more than 10 employees must keep OSHA 300 logs and post the 300A summary from February 1 to April 30 each year. Employers must report a fatality to OSHA within 8 hours, and an in-patient hospitalization, amputation, or loss of an eye within 24 hours (OSHA recordkeeping)

Step 9: Manage subcontractors and multi-employer worksites

On most jobsites, the majority of workers belong to someone else. Under OSHA’s multi-employer citation policy, a general contractor can be cited for hazards it created, controls, or should have corrected, even when its own employees weren’t exposed.

Build subcontractors into your system by following these:

  • Prequalify using EMR, TRIR, written programs, training records, and insurance.
  • Set requirements in the subcontract: site orientation, JHAs for their work, incident reporting, and participation in safety meetings.
  • Coordinate daily so one trade’s work doesn’t create hazards for another.
  • Track COIs and certifications so expired coverage or credentials are caught before work starts.
Managing safety across multiple subcontractors? Explore ways to organize onboarding, insurance documents, and safety records in one place. Improve subcontractor safety coordination.

Step 10: Measure, audit, and continuously improve

A system that isn’t measured drifts. Build three routines:

  • Monthly site audits against your own programs and procedures
  • Quarterly management reviews where leadership examines KPIs, incidents, audit findings, and open actions, then makes resourcing decisions
  • An annual system evaluation of the full SMS against OSHA’s recommended practices or ISO 45001

Feed what you learn back into JHAs, training, and site plans. That feedback loop is what turns a program into a system.

Construction safety KPIs to track

Track both lagging indicators, which measure outcomes, and leading indicators, which measure the activities that prevent them.

KPI Type How to measure Example target
TRIR Lagging Recordable cases × 200,000 ÷ hours worked Below your industry rate
DART Lagging DART cases × 200,000 ÷ hours worked Declining year over year
EMR Lagging From your rating bureau Below 1.00
Near-miss reports Leading Reports per 100 workers per month Rising in year one
Inspection completion Leading Completed inspections ÷ scheduled inspections 95% or higher
Corrective action closure Leading Average days to close Under 7 days for high-risk items
Training compliance Leading Current certifications ÷ required certifications 100%
Toolbox talk participation Leading Attendance ÷ crew size 90% or higher

A rising near-miss count in your first year is usually fine. It means workers trust the system enough to report.

A 90-day implementation timeline

Days 1–30: Plan

  • Leadership kickoff and signed safety policy
  • Baseline assessment and gap analysis
  • Roles and responsibilities defined
  • Safety committee formed
  • Tools and software selected

Days 31–60: Build

  • Written programs updated or created
  • JHA library for your most common tasks
  • Incident and near-miss reporting process live
  • Training matrix built
  • Pilot on one or two jobsites

Days 61–90: Roll out

  • Company-wide rollout with training for supervisors and crews
  • Subcontractor requirements added to new contracts
  • First monthly KPI review
  • Adjustments based on pilot feedback

Months 4–12: Sustain

  • Monthly site audits
  • Quarterly management reviews
  • First annual system evaluation

Paper vs. Digital for Construction Safety Management

Many SMS rollouts look good on paper and fade within months. The usual causes are practical:

Aspect Paper Spreadsheets Safety management software
Field capture Filled in after the fact, often incomplete Requires office entry Captured on site in real time
Evidence Photos rarely attached Stored separately Photos, timestamps, and GPS attached
Visibility across sites None until binders are collected Delayed, with potential version conflicts Live dashboards
Corrective actions Easily lost Manual follow-up Automatic assignment and reminders
Certifications Manual checks Manual checks Expiry alerts
Audits and renewals Hours of searching Hours of compiling Exportable reports

Software doesn’t replace the steps above. It makes them happen consistently, which is where most systems fail.

How KYRO AI Addresses Gaps in Manual Safety Management

Managing construction safety through spreadsheets, paper forms, and manual follow-ups can make it harder to track hazards, training, and incidents across job sites. KYRO AI helps teams manage these tasks digitally, keep records organized, and monitor safety performance.

KYRO AI’s construction safety platform supports each step of your rollout:

Step How KYRO helps
Worker participation Voice-powered forms let crews report hazards and near misses by speaking.
Hazard assessment Digital JHAs, pre-task plans, and mobile inspections with photos.
Hazard controls OSHA-aligned checklists for high-risk work.
Training Training and certification tracking with expiry alerts.
Incident management Field incident reports with photos, timestamps, and GPS, plus root cause and corrective action tracking.
Subcontractor management Subcontractor onboarding and certificate of insurance (COI) tracking.
Safety performance Dashboards for TRIR, DART, and leading indicators.

Common Implementation Mistakes to Avoid in Construction Safety Management System

  1. Buying software before defining processes. Tools amplify the process you have. Define it first.
  1. Writing programs nobody on site has read. If foremen can’t explain it, it doesn’t exist in the field.
  1. Treating near-miss volume as bad news. Punishing reports drives them underground.
  1. Not closing corrective actions. Findings without follow-through teach crews that reporting doesn’t matter.
  1. Leaving subcontractors out. They are often most of your workforce and most of your exposure.
  1. Measuring only lagging indicators. By the time TRIR moves, the injuries have already happened.
  1. Launching everywhere at once. A pilot on one or two jobsites exposes problems while they’re cheap to fix.
  1. Failing to track corrective actions. Record hazards and incidents, assign responsibility for fixing them, and check that issues are resolved.
  1. Not reviewing safety performance. Review inspection results, incident trends, and other safety indicators regularly to identify areas for improvement.
  1. Using outdated or scattered records. Keep safety plans, training records, inspection reports, and incident data organized and accessible to the right people.

Final Thoughts

A construction safety management system is what keeps safety working when the schedule gets tight, the crews change, and the safety manager can’t be everywhere. Start with leadership and a clear baseline, build the core processes, pilot before you scale, and measure what matters.

Book a demo with KYRO AI to see how teams run their safety management system from the field.

FAQs

What are the key elements of a construction safety management system?

OSHA’s recommended practices for construction identify seven core elements: management leadership, worker participation, hazard identification and assessment, hazard prevention and control, education and training, program evaluation and improvement, and coordination among host employers, contractors, and staffing agencies.

How long does it take to implement a safety management system?

Most contractors can build and roll out the core system in about 90 days: one month to plan, one to build and pilot, and one to roll out. Making it part of everyday culture takes 12 months or more of audits, reviews, and improvement.

What’s the difference between a safety program and a safety management system?

A safety program is your set of written policies and procedures. A safety management system is the full cycle that puts them into practice, checks whether they work, and improves them, including leadership, roles, training, reporting, audits, and management review.

Is a safety management system required by OSHA?

Federal OSHA requires specific written programs, training, and recordkeeping for many construction activities, but it does not generally require a complete SMS. Its recommended practices are voluntary guidance. Some state plans require injury and illness prevention programs.

‍
